Fire Alarm Battery Backup Calculation

Article

Fire Alarm Battery Backup Calculation

Oct 2026

Direct Answer

Fire alarm battery backup calculation estimates the standby battery capacity needed to keep the system operating during loss of normal power. It uses connected equipment’s standby and alarm currents, required operating durations, and applicable design factors. Final inputs must come from approved equipment data and project requirements.

1. Engineering Overview

Fire Alarm Battery Backup Calculation determines the standby battery capacity required to maintain the Fire Alarm System during loss of the normal power supply. The calculation should account for the system’s quiescent load, alarm load, required standby duration, design margins, battery characteristics and applicable project requirements.

2. Battery Backup Architecture

Normal AC Supply → Fire Alarm Power Supply / Charger → Standby Battery → Fire Alarm Control Panel → Field Devices / Notification Appliances / Interfaces

3. Purpose of Battery Calculation

The battery calculation verifies that the selected standby battery can supply the connected fire alarm equipment for the required standby period and the required alarm period after loss of normal power.

4. Basic Load Categories

Battery calculations generally consider two principal operating conditions:

  • Quiescent / standby load
  • Alarm load

The actual equipment loads should be taken from approved manufacturer data and the final system configuration.

5. Standby Load

Standby load is the current consumed by the fire alarm system while operating in its normal monitoring condition during loss of the primary power supply.

Typical loads may include:

  • Fire Alarm Control Panel
  • Detectors
  • Addressable loop devices
  • Monitoring modules
  • Communication equipment
  • Remote indicators
  • Other continuously energised system components

6. Alarm Load

Alarm load is the current consumed when the system is in an alarm condition.

Typical loads may include:

  • Hooters / sounders
  • Strobes
  • Sounder-strobes
  • Control modules
  • Interface equipment
  • Alarm communication equipment
  • Other equipment activated during alarm

7. Basic Calculation Principle

Required Battery Capacity = Standby Capacity Requirement + Alarm Capacity Requirement + Applicable Design Margin

The exact calculation methodology, standby period, alarm period and correction factors should follow the approved project requirements, applicable standards and manufacturer recommendations.

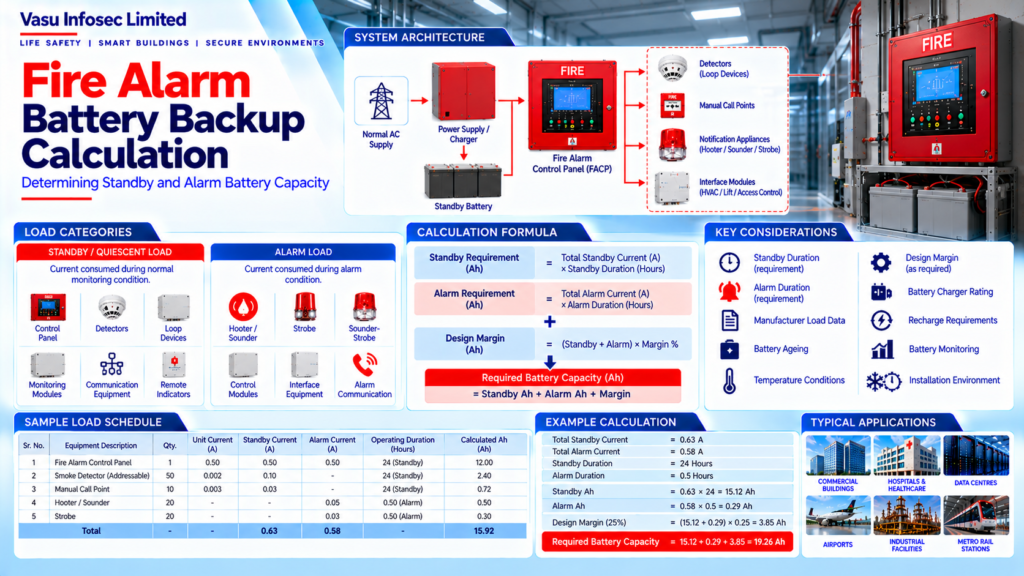

8. Load Schedule

A battery calculation should identify each connected load and its current requirement.

Typical schedule fields include:

  • Equipment description
  • Quantity
  • Unit current
  • Total current
  • Standby current
  • Alarm current
  • Operating duration
  • Calculated ampere-hours

9. Standby Ampere-Hour Calculation

Standby ampere-hour requirement is determined from the total standby current and the specified standby duration.

Standby Ah = Total Standby Current × Required Standby Duration

The resulting value should then be assessed against the applicable battery design requirements and correction factors.

10. Alarm Ampere-Hour Calculation

Alarm ampere-hour requirement is determined from the alarm current and the specified alarm duration.

Alarm Ah = Total Alarm Current × Required Alarm Duration

Where multiple alarm loads have different operating durations, each load should be calculated separately and then combined.

11. Battery Capacity Selection

The selected battery capacity should exceed the calculated requirement after considering applicable design factors, battery discharge characteristics, ageing considerations and the manufacturer’s permitted operating conditions.

12. Battery Charger Considerations

The battery charger should be capable of maintaining the standby batteries in a charged condition and supporting the required system operation in accordance with the approved equipment design.

Engineering review should consider:

  • Charger rating
  • Battery capacity
  • Recharge requirements
  • Battery monitoring
  • Power supply arrangement

13. Design Margin

An appropriate design margin should be applied where required by the approved design, applicable standard, manufacturer recommendation or project specification. The selected margin should be clearly identified in the calculation.

14. Battery Ageing & Temperature Considerations

Battery performance can be affected by ageing and operating temperature. The final battery selection should therefore consider the manufacturer’s published performance data and the actual installation environment.

15. Example Calculation Structure

Example calculation structure:

Total Standby Current = Sum of all standby loads

Total Alarm Current = Sum of all alarm loads

Standby Requirement = Standby Current × Standby Duration

Alarm Requirement = Alarm Current × Alarm Duration

Total Requirement = Standby Requirement + Alarm Requirement

Selected Battery Capacity ≥ Total Requirement × Applicable Design Factor

16. Testing & Verification

Battery backup performance should be verified during testing and commissioning.

Testing may include:

  • Normal power failure simulation
  • Standby operation verification
  • Alarm operation on battery supply
  • Battery voltage verification
  • Charger operation
  • Battery fault monitoring
  • Restoration of normal power

17. Common Engineering Considerations

Engineering review should verify:

  • Correct equipment load data
  • Complete load schedule
  • Standby duration
  • Alarm duration
  • Battery capacity
  • Design margin
  • Charger capacity
  • Battery ageing consideration
  • Environmental conditions
  • Manufacturer requirements

18. Documentation

Battery calculation documentation should include, as applicable:

  • Equipment load schedule
  • Manufacturer current data
  • Standby calculation
  • Alarm calculation
  • Battery selection
  • Design factor / margin
  • Charger information
  • Battery datasheet
  • Approved system architecture
  • Testing records

19. Engineering Objective

The engineering objective is:

Accurate Load Assessment → Correct Standby & Alarm Duration → Valid Ampere-Hour Calculation → Appropriate Design Margin → Correct Battery Selection → Adequate Charger Capacity → Verified Battery Performance → Reliable Fire Alarm Operation During Power Failure

Frequently Asked Questions

What information is needed for a battery backup calculation?

The calculation needs the connected equipment list, quantities, approved standby and alarm current data, required standby and alarm durations, and applicable design factors.

What is the difference between standby load and alarm load?

Standby load is the current consumed in the normal monitoring condition during loss of primary power. Alarm load is the current consumed when alarm devices and other programmed equipment operate.

How is standby ampere-hour capacity calculated?

The source document gives: Standby Ah = Total Standby Current × Required Standby Duration. The result must then be assessed against applicable design requirements and correction factors.

How is alarm ampere-hour capacity calculated?

The source document gives: Alarm Ah = Total Alarm Current × Required Alarm Duration. Where loads have different alarm durations, calculate each load separately and combine the results.

Can the calculated ampere-hour value be used directly as the battery rating?

Not automatically. The selected battery should account for applicable design factors, discharge characteristics, ageing, operating temperature and manufacturer-permitted conditions.

What should be checked during commissioning?

Checks may include simulated normal-power failure, standby operation, alarm operation on battery, battery voltage, charger operation, battery fault monitoring and restoration of normal power.
