Energy Management System Architecture

Article

Energy Management System Architecture

Oct 2026

Direct Answer

An Energy Management System (EnMS) within an Integrated Building Management System (IBMS) collects and presents energy data from approved electrical meters, utility meters and equipment interfaces. It supports centralised monitoring, historical analysis, dashboards and reporting; any optimisation or control functions must follow the approved project architecture and control philosophy.

1. Engineering Overview

An Energy Management System (EnMS) provides a structured platform for collecting, monitoring, analysing and managing energy-related information across a facility. Within an IBMS environment, the architecture integrates electrical meters, utility meters, equipment data, gateways, servers, databases, dashboards and reporting functions to support energy visibility and approved optimisation strategies.

2. Complete Architecture

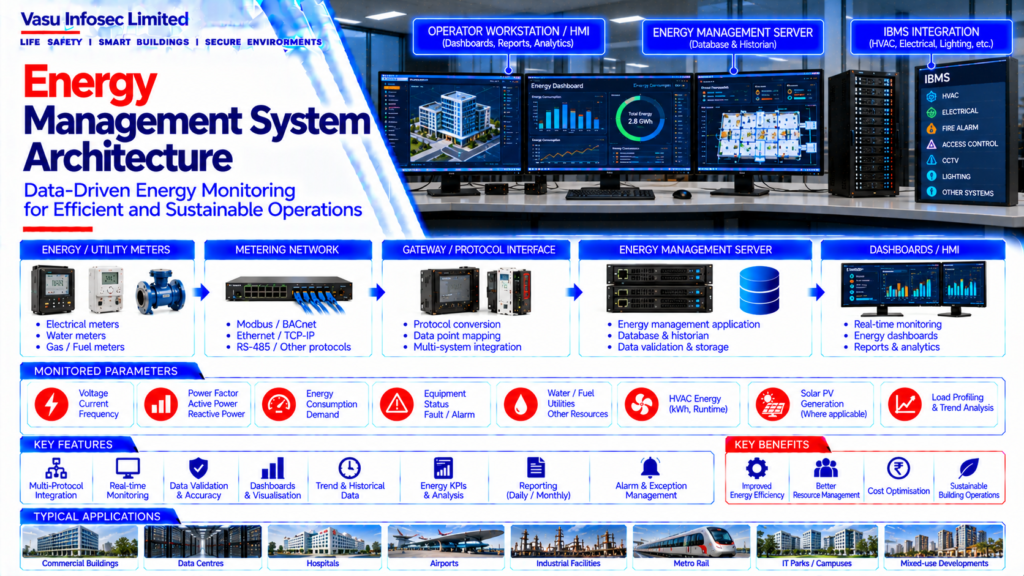

Energy Meters / Utility Meters / Equipment Data → Metering Network → Gateway / Protocol Interface → Energy Management Server / IBMS → Database / Historian → Dashboards / HMI → Reports & Analytics

Typical Data → Electricity → DG Generation → UPS Loads → HVAC Energy → Water / Fuel Utilities → Other Approved Energy Sources

3. Energy Data Acquisition

The acquisition layer collects energy and operational data from electrical meters, utility meters and approved equipment interfaces. Each source should have a defined measurement range, unit, address and communication method.

4. Electrical Energy Monitoring

Electrical energy monitoring may include active energy, reactive energy, apparent energy, demand, voltage, current, frequency and power factor. Data should be collected from appropriately selected and commissioned metering devices.

5. Utility Monitoring

Where required, the system may monitor other utility consumption such as water, fuel or other project-defined resources. Each utility should have an appropriate metering source and clearly defined measurement units.

6. Metering Architecture

Meters may communicate through Modbus, BACnet, Ethernet, RS-485 or other approved protocols. Meter addresses, registers, scaling, engineering units and communication parameters should be defined in the approved point schedule.

7. Gateway & Protocol Interface

Gateways may be used to connect meters or equipment using different communication protocols to the central energy management platform. Gateway configuration should preserve accurate values, timestamps, units and device status.

8. Data Validation

Collected energy data should be checked for communication errors, incorrect scaling, missing values, abnormal readings and inconsistent timestamps. Data validation should be completed during commissioning and periodically during operation.

9. Database & Historian

The energy management database stores measured values and historical information. Retention periods should support the approved reporting, analysis and operational requirements.

10. Energy Dashboards

Dashboards should provide clear visibility of energy consumption, demand, trends, equipment performance and relevant comparison indicators. Dashboard hierarchy may be arranged by site, building, floor, system or equipment.

11. Energy Consumption Analysis

Historical consumption data can be analysed to identify usage patterns, peak demand periods, abnormal consumption and opportunities for operational improvement. Analysis should use verified measurement data.

12. Demand Monitoring

Demand monitoring identifies periods of high electrical loading and supports operational assessment. Demand information should be presented with appropriate time intervals and measurement units.

13. Load Profiling

Load profiles provide time-based representation of energy consumption. Profiles may be used to compare operating periods, occupancy patterns, equipment schedules and other approved operational factors.

14. HVAC Energy Integration

HVAC energy information may be correlated with equipment status, operating hours, temperature and load data to support performance assessment. Control or optimisation functions should remain within the approved HVAC control philosophy.

15. Renewable Energy Integration

Where renewable generation such as solar PV is installed, generation, export, import and other approved parameters may be integrated into the energy management platform. Metering boundaries should be clearly defined.

16. Energy KPIs

Energy management may use approved KPIs such as consumption, demand, energy intensity, equipment runtime and system-level energy performance. KPI definitions should remain consistent across reporting periods.

17. Reporting Architecture

Reports may include daily, weekly, monthly or project-defined energy summaries, consumption trends, peak demand information, equipment comparisons and exception reports. Report content should be based on verified source data.

18. Alarm & Exception Management

The system may generate approved alerts for abnormal consumption, communication loss, meter faults or defined threshold exceedances. Alarm priorities and thresholds should be documented and reviewed.

19. Integration with IBMS

The Energy Management System may operate as a dedicated application or as an integrated function within IBMS. The interface should define the source of data, point ownership, communication method, data retention and authorised control functions.

20. Installation Requirements

Installation should verify:

  • Correct meters
  • Correct CT / PT configuration where applicable
  • Correct utility meters
  • Correct communication modules
  • Correct addressing
  • Correct register / point mapping
  • Correct units and scaling
  • Correct timestamps
  • Correct gateway configuration
  • Correct dashboards and reports

21. Testing & Commissioning

Commissioning should verify:

  • Meter readings
  • Communication links
  • Register mapping
  • Engineering units
  • Scaling
  • Data accuracy
  • Historical logging
  • Dashboard values
  • Alarm / exception functions
  • Reports
  • Gateway communication

22. Data Accuracy & Calibration

Energy measurements displayed in the management platform should be compared with source meter readings during commissioning. Meter configuration, scaling and communication mapping should be verified. Where applicable, meter calibration should follow the approved maintenance requirements.

23. Cybersecurity & User Management

Energy management servers, gateways and network interfaces should follow the approved cybersecurity architecture. User permissions should control access to dashboards, reports, configuration and authorised control functions.

24. Maintenance & Backup

Maintenance should include meter checks, communication diagnostics, gateway inspection, database backup, server health checks, data validation and configuration backup. Missing or abnormal data should be investigated and documented.

25. Design Change Control

Changes to meters, electrical distribution, utility sources, communication protocols, gateways, point lists, dashboards or energy calculation logic should be reviewed against the approved energy management architecture before implementation.

26. Documentation

Energy Management System documentation should include, as applicable:

  • Energy management architecture
  • Meter schedule
  • Utility meter schedule
  • Point list
  • Register mapping
  • Communication architecture
  • Gateway details
  • KPI definitions
  • Dashboard hierarchy
  • Reporting format
  • Testing and commissioning records
  • As-built drawings
  • O&M manual

27. Engineering Objective

The engineering objective is:

Accurate Metering → Reliable Data Acquisition → Secure Communication → Validated Energy Data → Centralised Monitoring → Meaningful Analytics → Effective Reporting → Approved Optimisation → Complete Commissioning → Reliable Energy Management
