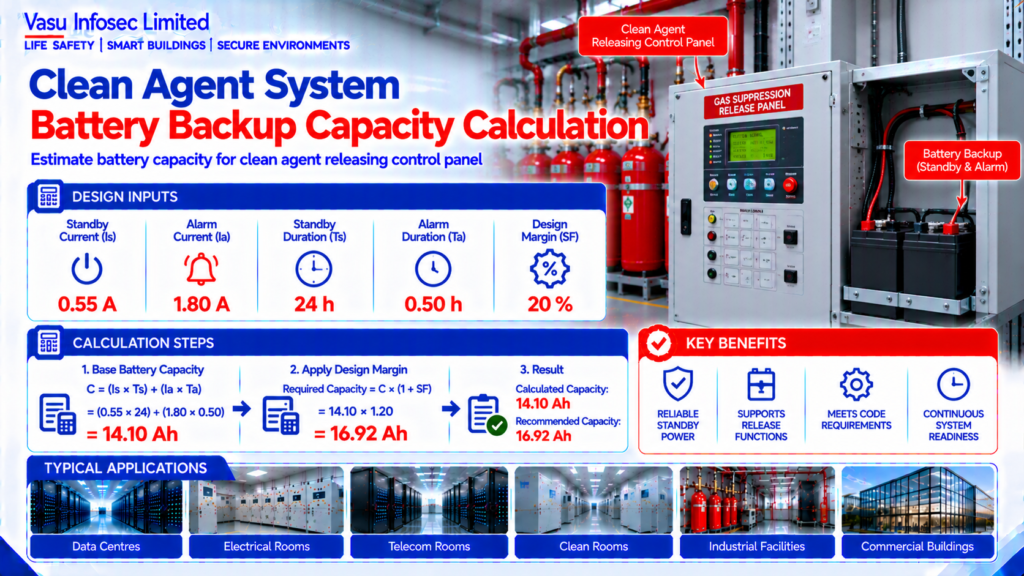

Clean Agent System Battery Backup Capacity Calculation

Engineering Calculation

Clean Agent System Battery Backup Capacity Calculation

Oct 2026

Direct Answer

Battery backup capacity is calculated from standby current, alarm current and their respective operating durations. In this example, the minimum recommended battery capacity is 16.92 Ah after applying a 20% engineering margin.

At a Glance

Item Source value / outcome
Resource ID EC-039
Standby Current 0.55 A
Alarm Current 1.80 A
Standby Duration 24 h
Alarm Duration 0.50 h
Design Margin 20 %
Engineering output Calculated Battery Capacity: 14.10 Ah; Recommended Minimum Capacity: 16.92 Ah

Calculation Method & Worked Example

Battery Capacity (Ah) = (Standby Current × Standby Time) + (Alarm Current × Alarm Time)

Required Capacity = Calculated Capacity × Safety Factor

Base Capacity = (0.55×24) + (1.8×0.5) = 14.10 Ah

Required Capacity = 14.10 × 1.20 = 16.92 Ah

A releasing panel drawing 0.55 A in standby for 24 hours and 1.80 A in alarm for 0.50 hours requires approximately 16.92 Ah after applying a 20% engineering margin.

Applicable Standards Listed in the Source

Standard Description
NFPA 72 National Fire Alarm and Signaling Code
NFPA 2001 Clean Agent Fire Extinguishing Systems
IS 2189 Fire Detection & Alarm Systems
OEM Manual Battery sizing requirements

Technical Content

1. Purpose

To estimate the minimum battery capacity required to support a clean agent releasing control panel during standby and alarm conditions.

2. Engineering Objective

To calculate the battery ampere-hour (Ah) capacity based on standby load, alarm load, standby duration and alarm duration.

3. Applicable Standards

Standards are listed above as supplied in the source document.

4. Design Inputs

Parameter Symbol Value Unit
Standby Current Is 0.55 A
Alarm Current Ia 1.80 A
Standby Duration Ts 24 h
Alarm Duration Ta 0.50 h
Design Margin SF 20 %

5. Assumptions

Battery ageing, temperature effects and a 20% engineering margin are considered. Final battery selection shall comply with the OEM requirements.

6. Formula(s)

Battery Capacity (Ah) = (Standby Current × Standby Time) + (Alarm Current × Alarm Time)

Required Capacity = Calculated Capacity × Safety Factor

7. Variables Explained

Is = Standby current; Ia = Alarm current; Ts = Standby duration; Ta = Alarm duration.

8. Step-by-Step Calculation

Base Capacity = (0.55×24) + (1.8×0.5) = 14.10 Ah

Required Capacity = 14.10 × 1.20 = 16.92 Ah

9. Worked Engineering Example

A releasing panel drawing 0.55 A in standby for 24 hours and 1.80 A in alarm for 0.50 hours requires approximately 16.92 Ah after applying a 20% engineering margin.

10. Engineering Output

Calculated Battery Capacity: 14.10 Ah

Recommended Minimum Capacity: 16.92 Ah

11. Design Considerations

Verify charger capacity, battery type, ambient temperature, ageing factor, release circuit loads and applicable code requirements.

12. Common Design Mistakes

Ignoring alarm duration, omitting safety margin, undersizing batteries and failing to verify OEM charging limits.

13. Practical Site Notes

Perform battery load testing during commissioning and replace batteries at the interval recommended by the manufacturer.

14. Limitations

Final battery capacity shall be confirmed using the approved equipment current ratings and project-specific standby requirements.

15. Related Engineering Systems

Gas Suppression Release Panel, Fire Alarm Control Panel, Releasing Circuits, Standby Power Supply.

16. Cross References

Related FAQ: Battery Backup

Related White Paper: VEP-002

Related Engineering Diagram: ED-039

19. URL Slug

ec-039-clean-agent-system-battery-backup-capacity-calculation

20. Keywords (15)

Battery Backup,NFPA72,NFPA2001,IS2189,Clean Agent,Release Panel,Battery Sizing,Engineering Calculation,Fire Protection,Standby Power,Ah Calculation,EPC,Consultant,Life Safety,Control Panel

21. AI Search Summary

Battery backup capacity is calculated from standby current, alarm current and their respective operating durations. In this example, the minimum recommended battery capacity is 16.92 Ah after applying a 20% engineering margin.

Frequently Asked Questions

What does this calculation determine?

To estimate the minimum battery capacity required to support a clean agent releasing control panel during standby and alarm conditions.

What is the result for this example?

Calculated Battery Capacity: 14.10 Ah
Recommended Minimum Capacity: 16.92 Ah

Can this preliminary calculation be used as final design approval?

Final battery capacity shall be confirmed using the approved equipment current ratings and project-specific standby requirements.

What should be verified before final design?

Verify charger capacity, battery type, ambient temperature, ageing factor, release circuit loads and applicable code requirements.
