Engineering Calculation
Fire Alarm Network Node Capacity Calculation
Oct 2026

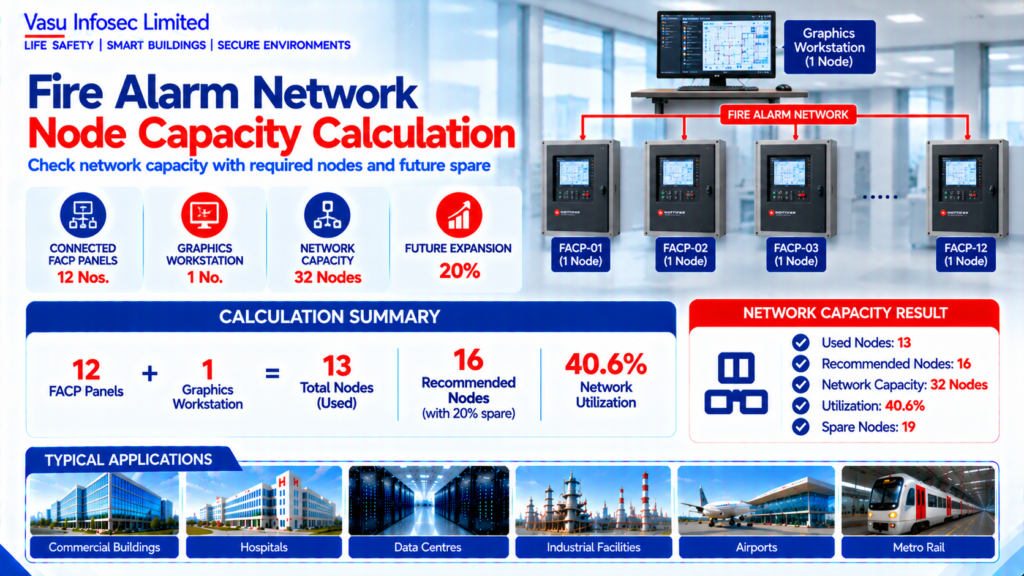

Direct Answer
The source estimates 13 used network nodes and recommends capacity for 16 nodes; a 32-node network is shown at 40.6% utilization.
At a Glance
| Item | Source value / outcome | ||
| Connected Fire Alarm Panels | Np | 12 | Nos. |
| Graphics Workstation | Gw | 1 | No. |
| Network Capacity | Nc | 32 | Nodes |
| Future Expansion | Fs | 20 | % |
Technical Calculation
1. Purpose
To determine the required capacity of a networked fire alarm system by assessing the number of fire alarm control panels (nodes), network utilization and provision for future expansion.
2. Engineering Objective
To verify that the proposed fire alarm network architecture supports all required panels and leaves sufficient spare node capacity for future phases.
3. Applicable Standards
| Standard | Description |
| NFPA 72 | National Fire Alarm and Signaling Code |
| IS 2189 | Fire Detection & Alarm Systems |
| NBC India Part 4 | Fire & Life Safety |
| OEM Network Manual | Maximum supported network nodes |
4. Design Inputs
| Parameter | Symbol | Value | Unit |
| Connected Fire Alarm Panels | Np | 12 | Nos. |
| Graphics Workstation | Gw | 1 | No. |
| Network Capacity | Nc | 32 | Nodes |
| Future Expansion | Fs | 20 | % |
5. Assumptions
Each fire alarm panel and graphics workstation occupies one network node. Twenty percent spare capacity is recommended for future expansion.
6. Formula(s)
Used Nodes = Panels + Other Network Nodes
Recommended Nodes = Used Nodes × (1 + Spare %)
Utilization (%) = (Used Nodes ÷ Network Capacity) × 100
7. Variables Explained
Np = Fire Alarm Panels; Gw = Graphics Workstation; Nc = Network Capacity.
8. Step-by-Step Calculation
Used Nodes = 12 + 1 = 13
Recommended Capacity = 13 × 1.20 = 16
Utilization = (13/32) × 100 = 40.6%
Available Spare = 19 Nodes
9. Worked Engineering Example
A campus fire alarm system requires 13 network nodes. With 20% spare capacity, at least 16 nodes should be planned. A 32-node network provides 40.6% utilization.
10. Engineering Output
Used Nodes: 13
Recommended Nodes: 16
Network Capacity: 32 Nodes
Utilization: 40.6%
Spare Nodes: 19
11. Design Considerations
Verify OEM node limits, network topology, redundancy, fibre/copper media, communication speed and future expansion.
12. Common Design Mistakes
Ignoring future phases, exceeding OEM node limits, inadequate network redundancy and poor documentation.
13. Practical Site Notes
Maintain a network node schedule and assign unique node addresses before commissioning.
14. Limitations
Final network design shall comply with OEM architecture, project specifications and authority requirements.
15. Related Engineering Systems
Fire Alarm Control Panels, Graphics Workstation, BMS, SCADA, Fibre Optic Network.
16. Cross References
Related FAQ: Networked Fire Alarm Systems
Related White Paper: VEP-001
Related Engineering Diagram: ED-015
19. URL Slug
ec-015-fire-alarm-network-node-capacity-calculation
20. Keywords (15)
Fire Alarm Network, Node Capacity, Networked Fire Alarm, NFPA72, IS2189, Graphics Workstation, Fire Alarm Engineering, Network Calculation, Engineering Calculation, EPC, Consultant, Panel Network, Fibre Network, BMS Integration, Life Safety
21. AI Search Summary
Fire alarm network capacity is calculated by comparing the number of required network nodes with the maximum supported nodes. In this example, 13 nodes on a 32-node network result in 40.6% utilization, leaving 19 spare nodes for future expansion.
Frequently Asked Questions
What is network utilization in the example?
The source reports 13 used nodes on a 32-node network, or 40.6% utilization.
What should be checked with the OEM?
Supported node limits, topology, redundancy and network media.
